Bishkek, Jan. 13, 2026. /Kabar/. Chakan Hydroelectric Power Plant (CHPP) has completed 80% of the construction work on Orto-Tokoy Hydroelectric Power Plant (HPP), according to the Kyrgyz Ministry of Energy.

According to the ministry, construction work at Orto-Tokoy HPP is actively continuing in accordance with the approved schedule.

In particular:

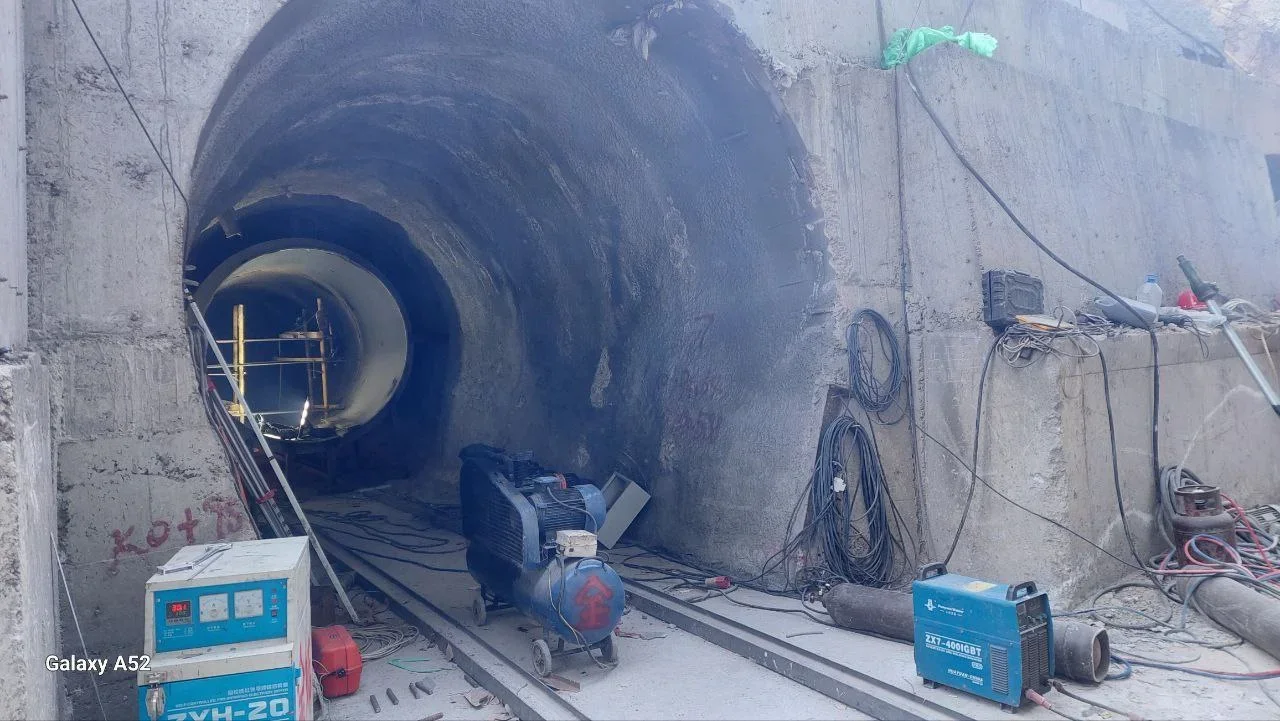

  • The excavation of a 950-meter-long diversion tunnel has been fully completed;
  • Concreting of the reinforced concrete lining of the water supply tunnel is underway;
  • Soil preparation and stabilization work, as well as the construction of the chamber walls at the branching junction, have been completed;

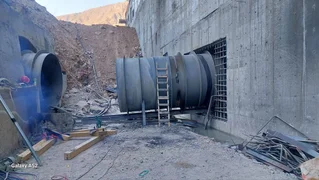

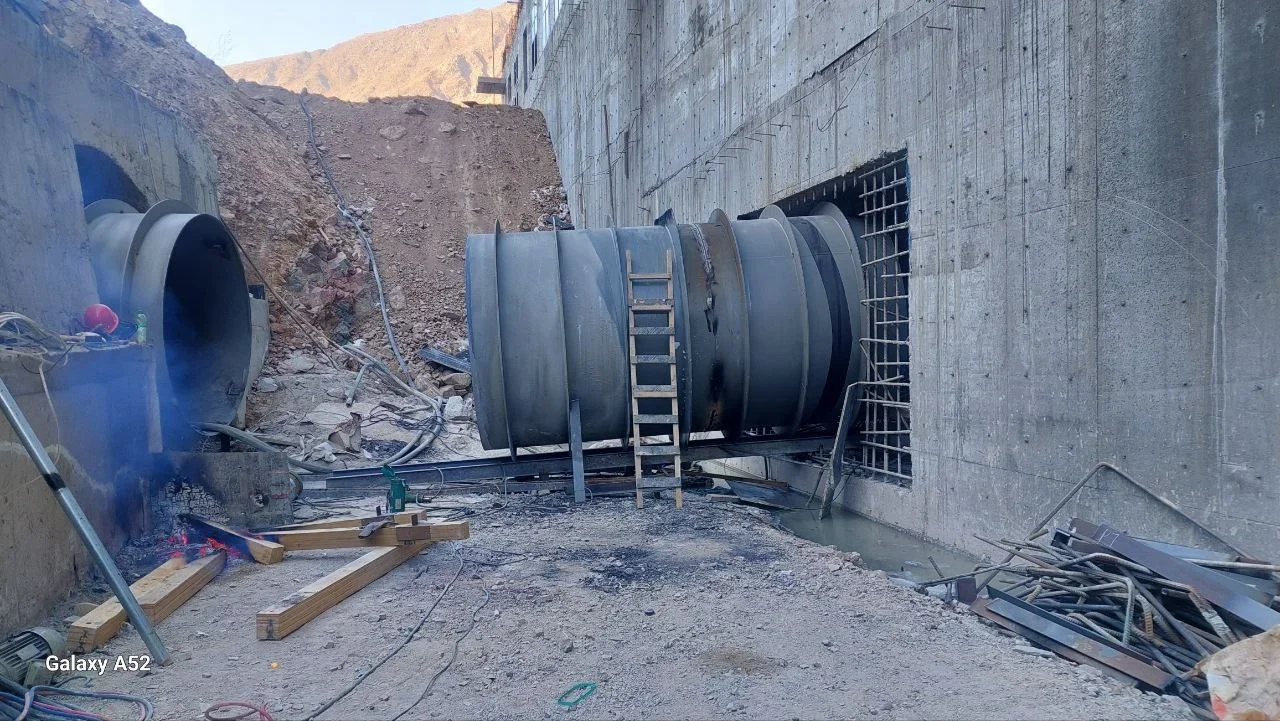

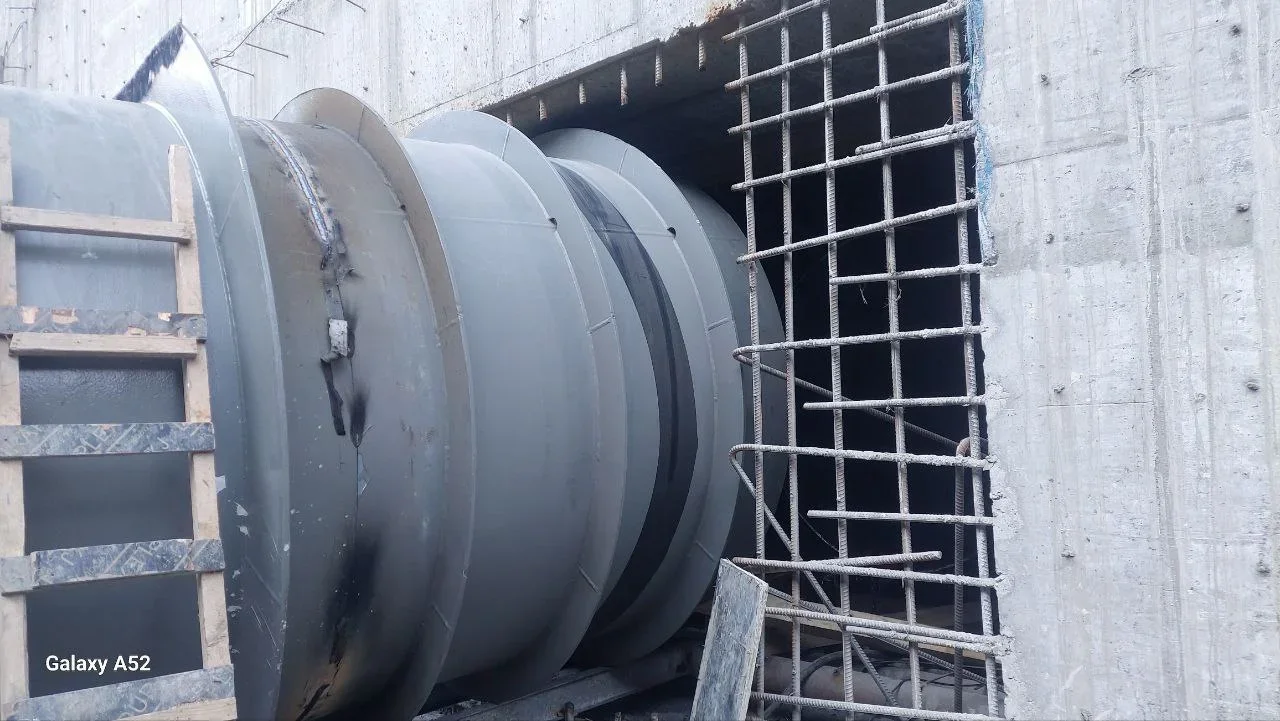

  • Preparations are underway for the installation of a tunnel interchange with three exits: 93.6 meters of metal structures have been installed and welded at one exit, and 74.4 meters at the second.

A number of key construction stages have also been completed at the hydroelectric power plant building:

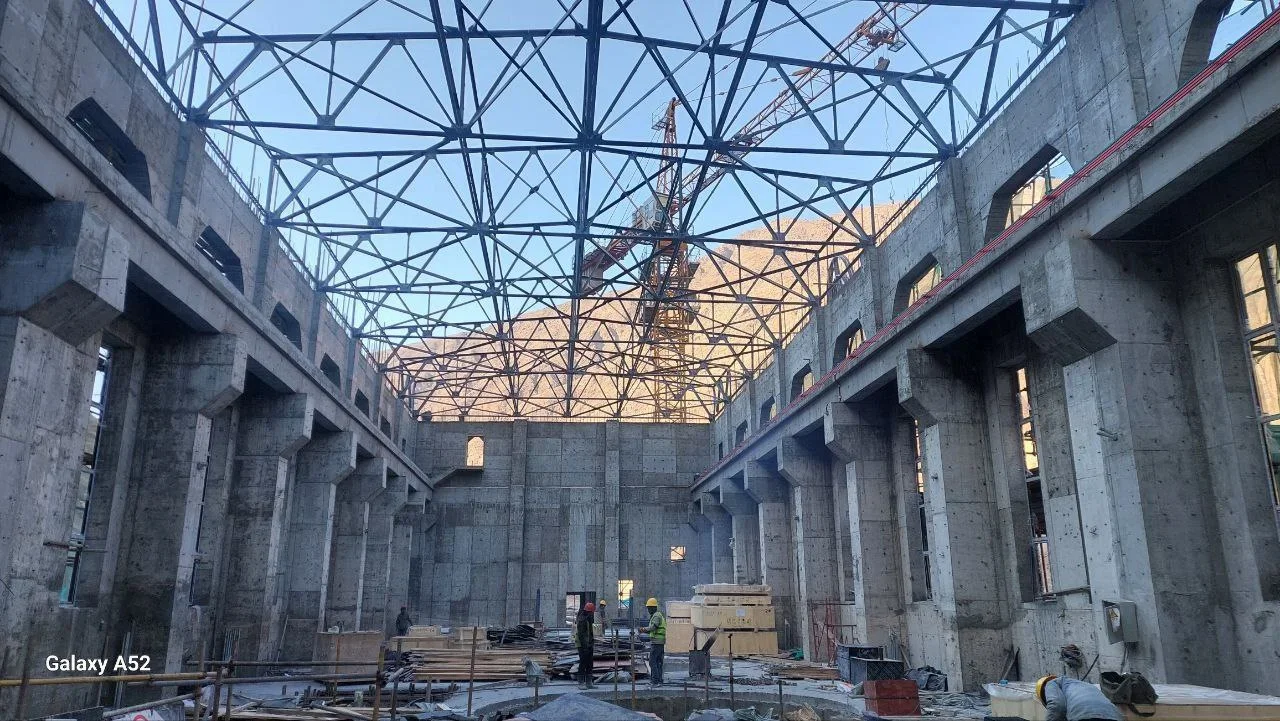

  • The construction of the hydroelectric power plant building is 90% complete;
  • The reinforcement and concreting of the columns for the lifting mechanisms of the downstream spillway gates has been fully completed;
  • The roof frame has been installed, and roofing work is underway;
  • The installation of turbines No. 1, 2, and 3, as well as the butterfly valves, has been completed.
  • The installed capacity of Orto-Tokoy HPP is 21 MW.

Construction is expected to be completed in the first half of 2026.
